Guide

The Custom Software Development Process, Step by Step

Exactly how a business problem becomes working software — the phases, the honest timelines, and what makes a project go well.

By Tim Wang · Development Manager, tPanel · LinkedIn ↗ · Updated August 2026

The custom software development process is the path from a business problem to working software, and it runs through seven phases: discovery, scoping and roadmap, design, development and integration, testing, launch and training, then iteration. Each phase answers a different question — first what the problem really is, then what to build, then how it should work, then the build itself, then whether it holds up, and finally how it improves over time.

This guide explains what happens in each phase, who needs to be involved, how to plan the timeline and what can cause delays. It draws on tPanel's custom business software projects for Australian businesses.

01

What Are the Phases of Software Development?

Custom software is built in distinct phases, each with a clear purpose. Naming them up front makes the rest of the project legible — you always know where you are and what comes next. The standard sequence looks like this:

  • Discovery — understand the workflow: who does what, where data lives, and where it gets stuck.
  • Scope & roadmap — decide what to build first, in what order, and what can wait.
  • UX & data model design — design the screens, statuses, fields and reports before any code is written.
  • Development & integration — build the software and connect it to the tools you already use.
  • Testing & QA — check that it works, including the awkward edge cases.
  • Launch & training — get the system live and the team confident using it.
  • Iteration & maintenance — refine and extend the system as the business learns from it.

The first three phases are mostly about decisions; the last four are about building, proving and improving. Skipping or rushing the early phases is the single most common reason projects overrun, because every wrong assumption gets baked into code that then has to be unpicked.

The phases are not a one-way waterfall. tPanel delivers iteratively, in short cycles, getting working software in front of your team early rather than disappearing for months against a giant upfront specification. It is worth knowing the three common delivery styles so the rest of this guide makes sense:

  • Waterfall — every requirement is specified in full first, then built in one long pass, then tested, then released. Changes found late may require earlier design and development work to be revisited.
  • Agile / iterative — the system is built in short cycles, each producing something usable, with direction adjusted as real usage reveals what matters. Scope flexes; the deadline and budget are managed by choosing what makes each cycle.
  • Hybrid — a light upfront scope to agree the shape and budget, then iterative delivery underneath it. This is what tPanel uses in practice: enough planning to give you an honest roadmap, then short build cycles you can actually see progress on.

The MVP-first approach later in this guide is the hybrid style in action — agree the shape, build the core first, then grow it on evidence.

Watch instead: the seven phases, honest timelines and the pitfalls that stretch a project — walked through in two minutes by tPanel. Watch on YouTube
02

A Walk Through Each Phase

Here is what actually happens inside each phase of a custom build, from the first conversation to ongoing support.

Discovery

We work with your team to map each step, identify who is responsible and locate the data it uses. This includes repeated data entry, shared spreadsheets and points where work is delayed.

Scope & Roadmap

We agree on the first workflow to deliver, the roles and permissions it needs, and any required integrations. Other features are placed on a roadmap for later releases.

UX & Data Model Design

We design the screens, record statuses, fields and reports. The data model describes how information is related: for example, a job belongs to a customer and contains several tasks.

Development & Integration

We build the workflow and connect the existing accounting, email, payment, scheduling or industry tools it needs. These system integrations reduce the need to copy data between applications.

Testing & QA

We test the usual workflow as well as missing data, invalid inputs and permission boundaries. Your team helps test scenarios from daily work so issues can be addressed before rollout.

Launch & Training

We prepare the live system, migrate the agreed data and train the people who will use it. A staged rollout gives the team time to practise and resolve issues before wider use.

Iteration & Maintenance

The first weeks focus on issues found during daily use. Further features, reports and integrations are then planned around the team's priorities. Ongoing maintenance includes monitoring, backups, security and dependency updates, and support.

03

How Long Does Each Phase Take?

Timelines vary with scope, but honest ranges help you plan. A focused MVP — one workflow done well — typically runs around 6 to 12 weeks end to end. A medium system — say two to four connected workflows with three or four integrations — usually runs around four to seven months, delivered in phases rather than all at once. The build itself is always the longest stretch; discovery and design are shorter but disproportionately important.

The table below is illustrative — every project is different — but it shows how the same phases stretch as scope grows. The MVP column matches a small single-workflow build; the medium column matches a mid-size custom system (custom CRM, internal or operations system) in the A$12,000–45,000 range described in our cost guide.

PhaseFocused MVP (illustrative)Medium system (illustrative)
Discovery3 days – 1.5 weeks1.5 – 3 weeks
Scope & design1 – 2 weeks2 – 4 weeks
Development & integration4 – 8 weeks3 – 5 months (in phases)
Testing & QA1 – 1.5 weeks (overlaps the build)ongoing per phase (overlaps the build)
Launch & training2 days – 1 week1 – 2 weeks (often staged)

What stretches a timeline is usually scope, slow decisions on the client side, and complex integrations with older systems. For how those same factors move the budget, see our guide on custom software cost in Australia.

Two-lane phase timeline. A focused MVP runs 6–12 weeks in total: discovery 3 days to 1.5 weeks, scope and design 1–2 weeks, development and integration 4–8 weeks, testing and QA 1–1.5 weeks overlapping the build, and launch and training 2 days to 1 week. A medium system, delivered in phases, runs to roughly 29 weeks: discovery 1.5–3 weeks, scope and design 2–4 weeks, development and integration 3–5 months in phases, testing and QA ongoing per phase and again overlapping the build, and launch and training 1–2 weeks, often staged. Both lanes are drawn on one shared week scale running from 0 to 28 weeks, with bar lengths taking the upper end of each illustrative range, and in both the QA bar sits across the development bar rather than after it.
Phase durations for a focused MVP and for a medium system. QA overlaps the build — it is not a separate stage bolted on at the end.
04

Why a Phased, MVP-First Approach Reduces Risk

An MVP is a first usable version that supports a complete workflow. Delivering it early lets the team try the system in daily work and decide what needs changing or adding. This helps limit the initial scope and uncover incorrect assumptions sooner.

  • You learn from real use. A workflow always looks different once people actually click through it, and changes are cheap when the system is still small.
  • You spend in proportion to proven value. Each phase is justified by how the last one performed, so budget follows results rather than a wishlist.
  • You avoid building features nobody uses. Plenty of "must-have" requests quietly fall away once the core is live and the real bottlenecks become visible.
  • You can change direction cheaply. Phased delivery means a course correction costs a sprint, not the whole project.

This is also why a custom build often beats configuring a packaged product around your edge cases. If you are still weighing that decision, our guide on custom software vs off-the-shelf compares the two honestly.

05

What the Client Needs to Provide

A custom build is a partnership, and a few things from your side make the difference between a smooth project and a stalled one. You do not need a technical specification or any software knowledge — defining the build is the developer's job. What you do need to bring is access, decisions and feedback.

  • People who know the workflow. Time with the staff who actually do the work daily, not just managers describing it from memory — that is where the real requirements live.
  • A single decision-maker. One empowered person who can settle trade-offs quickly. This is the most valuable thing a client provides; nothing slows a project like decisions waiting on a committee. The cost of not having one is real: as an illustrative example, when a single yes-or-no question has to circle a committee, a one-day decision can take two weeks — and if that happens a handful of times, a 10-week build quietly becomes a 16-week one. Those figures are illustrative, but the pattern is not.
  • Honest testing feedback. Your team trying the system and saying plainly what works and what does not, before launch rather than after.
  • Access and data. Logins for the tools you want connected, and any existing data — spreadsheets, exports, current databases — that needs to migrate across.

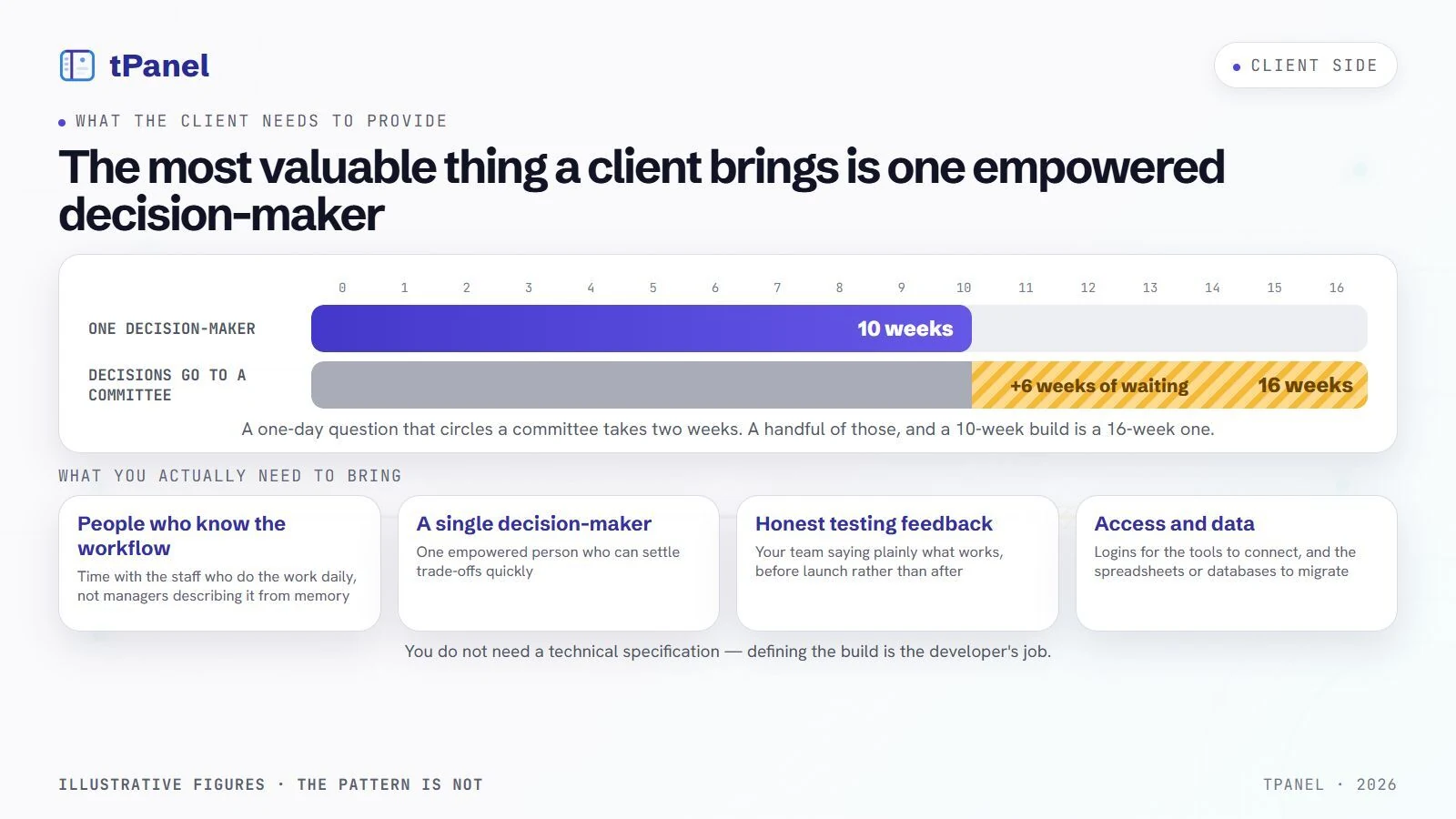

Timeline comparison across 16 weeks. With one empowered decision-maker the build finishes in 10 weeks. When decisions go to a committee the same build stretches to 16 weeks, the extra six weeks of waiting shown as a hatched extension. Below, four cards list what the client actually needs to bring: people who know the workflow — time with the staff who do the work daily, not managers describing it from memory; a single decision-maker who can settle trade-offs quickly; honest testing feedback before launch rather than after; and access and data, meaning logins for the tools to connect and the spreadsheets or databases to migrate. You do not need a technical specification — defining the build is the developer's job.
What the client side actually supplies — and what committee decision-making quietly costs in weeks. The figures are illustrative; the pattern is not.
06

Common Pitfalls That Derail Projects

Unclear scope, delayed decisions, incomplete requirements and poor launch preparation can all slow a project. Agree how these issues will be handled before development begins.

  • Unclear or open-ended scope. If "done" is never defined, the project never ends. A clear MVP and roadmap keep scope honest.
  • No single decision-maker. When every choice goes to a group, momentum dies and the build drifts. One empowered owner keeps it moving.
  • Skipping discovery. Jumping straight to building means coding against assumptions, then rebuilding when the real workflow surfaces.
  • Big-bang launches. Switching everyone over at once, with no rehearsal or fallback, turns small issues into a crisis. Phased rollouts are calmer and safer.
  • Treating launch as the finish line. The system is a living tool. Planning for iteration and maintenance from the start is what keeps it useful a year later.
07

How tPanel Runs the Process

tPanel runs every custom software development project through these phases, kept deliberately lightweight so you spend time on decisions, not paperwork. We start with discovery to understand your workflow, agree on an MVP and roadmap, design the data model and screens, then build and integrate in short cycles you can see progress on. Testing runs alongside the build, launch is staged with training, and we stay on for iteration and maintenance afterwards.

We build a range of systems this way — internal tools, lead and operations platforms, and custom CRM development tailored to how your team actually sells and serves. Whatever the system, the process is the same: understand the work first, build the smallest version that delivers, then grow it on evidence. If you have a workflow that needs fixing, the best next step is a short discovery conversation — tell us what is slowing your team down and we will map out how it would work.

FAQ

Frequently asked questions about the development process

Can’t see your question here? Tell us what you’re trying to build and we’ll answer it directly — no sales script.

What are the stages of custom software development?

There are seven stages: discovery (understanding the workflow and where data moves), scope and roadmap (defining the MVP, phases, roles and integrations), UX and data model design (screens, statuses, fields and dashboards), development and integration (building the software and connecting existing tools), testing and QA, launch and training, and iteration and maintenance. The early stages are about decisions; the later stages are about building and refining.

How long does custom software take to build?

A focused MVP that solves one workflow well typically takes around 6 to 12 weeks from kick-off to launch. Larger builds that span several teams, replace multiple tools or require deep integrations usually run three to six months or more, delivered in phases. Discovery and design take one to three weeks, the build is the longest stretch, and testing plus launch usually add one to two weeks.

What is an MVP and why start there?

An MVP, or minimum viable product, is the smallest version of the system that delivers real value in daily use — the core workflow rather than every feature anyone has ever asked for. Starting with an MVP gets working software in front of your team sooner, lets you learn from real usage before spending more, and avoids building features nobody ends up using. After launch the system grows in phases based on what people actually need.

What do we need to provide as the client?

You provide access to the people who genuinely know the workflow, timely decisions when trade-offs come up, and honest feedback during testing. You also supply access to the systems you want connected and any data that needs to be migrated. You do not need a technical specification — that is the developer's job. A single, empowered decision-maker on your side is the most valuable thing you can offer.

What happens after launch?

After launch the work shifts to iteration and maintenance. The first few weeks focus on fixing rough edges and adjusting things real usage reveals. From there the system grows in planned phases — new features, more integrations and reports — based on what your team needs next. Maintenance covers updates, monitoring, backups and support so the software stays reliable as your business changes.

Have a workflow worth building software around?

Tell us what is slowing your team down. We will map the phases, give you an honest timeline, and show you what an MVP would look like.
